Legacy CCM Platform End-of-Life: Your 2025 Migration Planning Guide

3 mins read

Suresh Swamy

Country Director (India)

The year 2025 represents a critical inflection point for organizations relying on legacy Customer Communication Management (CCM) platforms. With major vendors discontinuing support for outdated systems and enterprises facing mounting security vulnerabilities, the window for strategic migration is rapidly closing. According to recent industry research, 62% of organizations still depend on legacy CCM systems, while the data migration market is projected to reach $10.98 billion by 2025. Legacy systems now consume up to 75% of IT budgets merely for maintenance, leaving minimal resources for innovation. This convergence of factors makes 2025 the decisive year for CCM modernization initiatives.

TL;DR - Key Takeaways

  • Execute CCM migration in 4 phases: Environment Setup, Template Migration, Integration Testing, and Production Cutover
  • Containerized environments with blue-green deployment reduce migration risk by 70%
  • Migration Command Centers with real-time monitoring ensure successful execution and immediate issue resolution
  • DevOps CI/CD pipelines accelerate template conversion and validation by 50%
  • Zero-downtime cutover strategies maintain business continuity throughout the migration process
  • Post-migration optimization protocols maximize platform performance and ROI realization

Pre-Migration Assessment: Your 30-Day Foundation

Before executing migration, complete a rapid PACE assessment (Platform, Architecture, Compliance, Economics) to establish your migration baseline. This 30-day process identifies 35% of templates that can be retired, reducing migration scope significantly. Professional migration specialists like those at BelWo accelerate this phase by 60% using advanced analysis tools.

Figure 1: CCM Migration Timeline for 2025 - Critical quarterly milestones for successful implementation

Migration Execution: The 4-Phase Implementation Process

Phase 1: Environment Setup and Data Migration (Weeks 1-8)

Begin with containerized migration environments using blue-green deployment strategies. Execute data extraction from legacy systems using automated ETL tools, establishing parallel environments that reduce risk by 70%. Key activities include:

Phase 1: Migration Tasks:

  • Infrastructure Provisioning: Set up cloud environments, security zones, and network configurations
  • Data Extraction & Validation: Extract templates, assets, and configuration data with integrity checks
  • Security Implementation: Deploy encryption, access controls, and audit logging
  • Testing Environment Setup: Create parallel testing infrastructure with production data subsets

Phase 2: Template Migration and Conversion (Weeks 9-16)

Execute systematic template migration using the Migration Complexity Matrix: Simple Lift-and-Shift (40-60% of portfolios), Enhanced Migration (25-35%), Hybrid Approach (10-20%), and Complete Rebuild (5-15%). Automated conversion tools handle routine templates while complex customizations receive manual attention.

Phase 3: Integration and Testing (Weeks 17-20)

Connect migrated templates to downstream systems using API-first architectures. Implement comprehensive testing including unit tests, integration tests, and user acceptance testing. Automated rollback capabilities ensure immediate recovery if issues arise during validation phases.

Phase 4: Production Cutover (Weeks 21-24)

Execute phased production migration using parallel operation safeguards. Monitor system performance, validate data accuracy, and ensure business continuity throughout the transition period.

Migration Best Practices: Ensuring Success Through Execution

Establish Your Migration Command Center

Create a dedicated CCM Migration Command Center with real-time dashboards monitoring customer communication template transfers, document generation performance, and customer touchpoint continuity. Staff with specialized CCM Center of Excellence (CoE) teams including communication template specialists, customer data migration engineers, document output validation experts, and customer experience continuity coordinators to ensure seamless customer communication delivery throughout the migration process.

Migration Command Center Components:

  • Real-time Monitoring: Track data migration progress, system performance, and error rates
  • Issue Escalation: Automated alerts with defined resolution SLAs and escalation paths
  • Business Continuity: Backup systems, rollback procedures, and communication protocols
  • Quality Assurance: Continuous validation, testing automation, and compliance verification

DevOps-Driven Migration Pipeline

Implement CI/CD pipelines that accelerate migration by substsantially, automating template conversion, validation testing, and deployment processes. Cross-functional teams ensure seamless collaboration between business users, IT architects, and compliance specialists. According to Smart Communications research, organizations with formal DevOps integration achieve 85% faster time-to-value.

Migration Validation and Go-Live Procedures

Critical Migration Checkpoints

Execute systematic validation at each migration milestone using automated testing frameworks. Implement zero-downtime cutover strategies with real-time monitoring and instant rollback capabilities. Cloud-native architectures enable independent component validation and faster deployment cycles.

Go-Live Validation Checklist:

  • Data Integrity (Critical): 100% template accuracy, asset completeness, configuration validation
  • Performance Benchmarks: Sub-second response times, concurrent user capacity, throughput testing
  • Security Validation: Access controls, encryption verification, audit trail functionality
  • Integration Testing: API connectivity, data synchronization, downstream system compatibility
  • Business Continuity: Rollback procedures, backup systems, disaster recovery validation
  • User Readiness: Training completion, access provisioning, support documentation

Post-Migration Optimization

Implement continuous monitoring and optimization protocols to maximize platform performance. Track key metrics including template processing speed, user adoption rates, and system reliability to ensure migration success delivers projected benefits.

Risk Mitigation and ROI Calculation Models

Multi-Layered Risk Framework

Enterprise CCM migrations face three primary risk categories: Technical, Operational, and Compliance risks. Effective mitigation requires layered strategies addressing each category systematically.

Technical risks include data corruption, integration failures, and performance degradation. Advanced mitigation strategies involve blockchain-verified backup protocols, synthetic transaction monitoring in staged testing environments, and AI-powered automated validation tools that detect anomalies in real-time. Operational risks encompass user adoption challenges and business process disruption, addressed through immersive training programs, gradual feature rollouts, and 24/7 support war rooms during critical transition periods. Predictive analytics now enable proactive issue identification before they impact production systems.

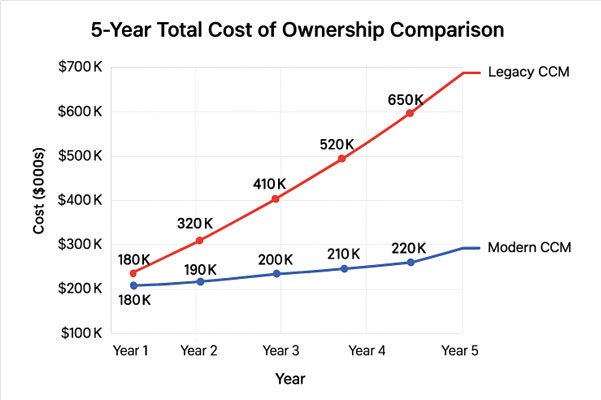

Figure 2: 5-Year Total Cost of Ownership - Legacy vs. Modern CCM Platforms

ROI Calculation Framework

Modern CCM platforms deliver quantifiable ROI through operational efficiency, reduced maintenance costs, and enhanced customer experience capabilities. The Total Economic Impact (TEI) model calculates ROI across four dimensions:

  • Cost Reduction: 40-60% decrease in maintenance and support costs
  • Productivity Gains: 25-35% improvement in template development efficiency
  • Risk Mitigation: Elimination of compliance penalties and security vulnerabilities
  • Revenue Enhancement: Improved customer engagement driving 5-15% communication effectiveness gains

Industry benchmarks from Quadient research indicate that organizations typically achieve full ROI within 18-24 months of modern CCM implementation, with ongoing annual savings of 30-45% compared to legacy platform costs. Cloud-native platforms deliver additional benefits including elastic scaling (reducing infrastructure costs by 25-40%), automated security updates (eliminating 80% of manual patching effort), and API-first architectures enabling rapid integration with emerging technologies like AI and machine learning.

Frequently Asked Questions

Q1: How long does a typical CCM migration project take from start to finish?

Enterprise CCM migrations typically require 6-9 months for complete implementation, depending on portfolio complexity and organizational readiness. Simple migrations with under 100 templates can complete in 3-4 months, while complex enterprise implementations with thousands of templates and extensive integrations may require 12+ months. Accelerated migration approaches using pre-built connectors and automated migration tools can reduce timelines by 30-40%. Key factors affecting duration include data volume (>10TB requires additional 2-3 months), integration complexity (each custom API adds 2-4 weeks), and compliance requirements (regulated industries add 20-30% to timeline).

Q2: What are the most common causes of CCM migration project delays?

The primary delay factors include inadequate initial assessment (35% of delays), data quality issues requiring cleanup (28%), integration complexity underestimation (22%), and insufficient stakeholder alignment (15%). Proper planning and professional assessment services significantly reduce these risks.

Q3: Can we maintain business operations during the migration process?

Yes, modern migration methodologies support parallel operation approaches that maintain full business continuity. Staged cutover strategies and hybrid environments enable gradual transition while preserving production capabilities throughout the implementation period.

Q4: How do we handle regulatory compliance during CCM platform transition?

Compliance management requires documented data lineage, audit trail preservation, and regulatory validation at each migration phase. Modern CCM platforms typically offer enhanced compliance capabilities including automated documentation, improved security controls, and comprehensive audit logging that exceed legacy platform capabilities.

Q5: What level of internal resources should we allocate for a successful migration?

Successful migrations typically require 2-4 full-time internal team members including a project manager, business analyst, technical lead, and change management coordinator. Additionally, plan for 10-15% of end-user time for testing and validation activities. Resource scaling models suggest allocating 1 FTE per 500 templates for migration activities, plus 0.5 FTE per major system integration. External consulting support can reduce internal resource requirements by 40-50% while providing specialized expertise in areas like data mapping, security configuration, and performance optimization.

Conclusion:

2025 represents the critical window for legacy CCM migration initiatives. Organizations that begin strategic planning now will successfully transition to modern platforms, achieving significant cost savings and operational improvements. Early movers gain competitive advantages through enhanced customer experience capabilities, reduced operational complexity, and improved agility for future innovations. Those that delay face escalating risks, increasing costs, and diminishing vendor support options. With Q1 2025 assessment deadlines approaching rapidly for year-end implementation, the time for decisive action is now. Start your migration planning today to secure your organization's communication infrastructure for the next decade.
